Most Salesforce implementations that fail do so quietly. Not in a single catastrophic moment, but through a slow accumulation of decisions that looked reasonable in isolation. Understanding the salesforce implementation failure root causes requires looking past the symptoms; missed deadlines, adoption gaps, runaway customization; and into the structural decisions made in the first 90 days.
The pattern repeats across industries and org sizes. The technology rarely fails. The architecture does.
Why Requirements Gathering Is Where Most Projects Die
The failure is almost never in the build phase. By the time a project is visibly in trouble, the damage was done during discovery.
In practice, requirements gathering on Salesforce projects gets treated as a documentation exercise rather than an architectural one. Business stakeholders describe their current process. Consultants transcribe it into user stories. Nobody asks whether the process itself is worth automating, or whether the data model that supports it will hold under load.
The result is a configuration that mirrors a broken process with high fidelity. Flow orchestration that replicates manual workarounds. Object relationships that encode org chart politics rather than data reality. Validation rules that enforce exceptions as if they were rules.
The architectural decision that matters here is whether the team has a solution architect with authority to push back on requirements, not just capture them. A common pattern in enterprise orgs is to staff discovery with business analysts and bring in architects only after the scope is locked. That sequencing guarantees drift between what was designed and what the platform can sustainably support.
The Data Model Problem Nobody Talks About Until It’s Too Late

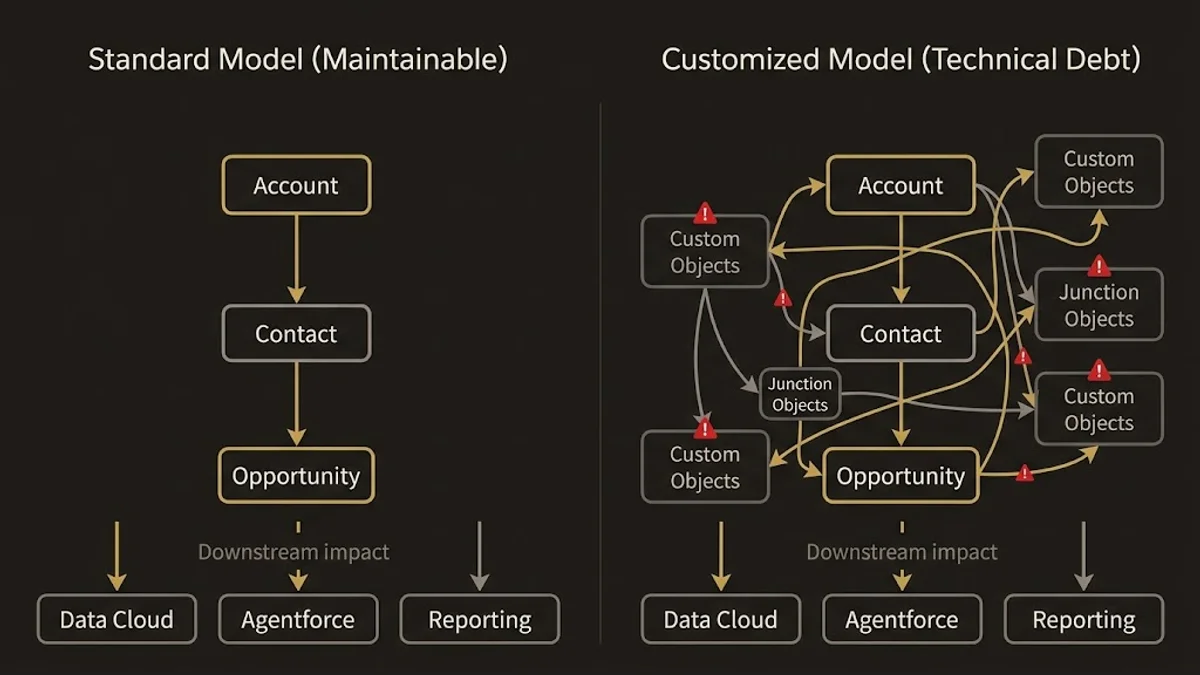

Salesforce’s standard data model is opinionated. Account-Contact-Opportunity is not just a schema; it’s a set of assumptions about how sales relationships work. When an org’s actual business model diverges from those assumptions, the instinct is to customize. Custom objects, custom relationships, junction objects layered on junction objects.

This is where technical debt compounds fastest. Each deviation from the standard model increases the cost of every future change: integrations, reporting, Data Cloud Data Streams, Agentforce Actions that need to traverse object relationships to surface context. The salesforce technical debt assessment framework maps exactly how these deviations accumulate into architectural risk over time.
The failure mode is not that customization is wrong. It’s that customization decisions get made at the field and object level without anyone modeling the downstream consequences. A custom Account hierarchy that made sense for one business unit becomes the reason Data Cloud Identity Resolution rulesets can’t resolve duplicates three years later. A junction object added to support a reporting requirement becomes a bottleneck in every Flow that touches the related records.
The architecture that works here is to treat the data model as a first-class design artifact, reviewed before any configuration begins, with explicit decisions documented about where and why the org deviates from standard objects.
Governance Gaps That Compound Over Time
A Salesforce org without a governance model is not a stable system. It’s a system in slow decay.
Governance failures show up in predictable ways: multiple teams deploying to production without coordination, sandbox strategies that don’t reflect production data volume, change sets that overwrite each other’s work, and no single owner for cross-functional decisions about shared objects like Account or Contact.
The deeper problem is that governance is treated as a process concern rather than an architectural one. In reality, the decisions that governance needs to enforce are architectural: who owns the data model, what triggers the review of a new custom object, how integration middleware changes get coordinated with Salesforce configuration changes.
At the scale of orgs running 200+ active users across multiple business units, the absence of a Center of Excellence creates a specific failure pattern. Each team optimizes locally. Sales Cloud gets customized for the sales team’s workflow. Service Cloud gets customized for the support team’s workflow. Nobody owns the Account object that both teams share, so it accumulates fields from both directions until it’s carrying 300+ fields and nobody can explain what half of them mean.
The fix is not a governance committee. It’s an architectural ownership model: named owners for shared objects, a defined process for evaluating cross-cloud impact, and a sandbox strategy that makes it impossible to deploy changes that haven’t been tested against realistic data volumes.
Integration Architecture as a Failure Multiplier
Integration is where implementation failures accelerate from manageable to catastrophic.

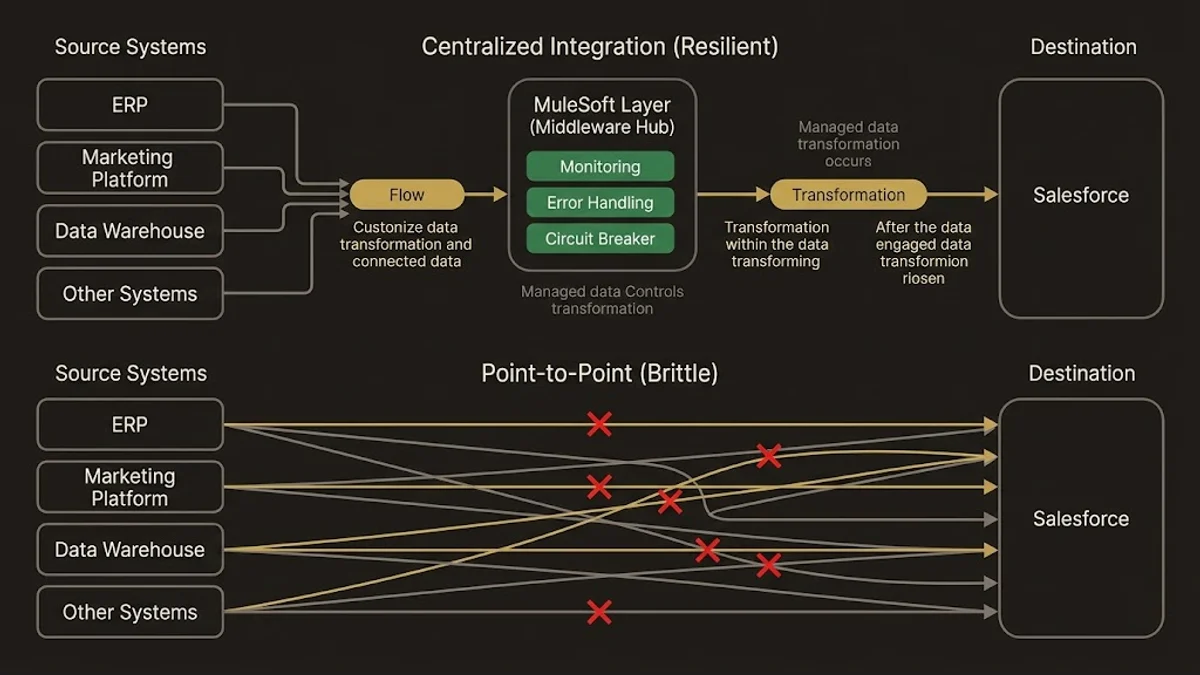

The most common pattern is point-to-point integration built during the initial implementation because it was faster than standing up a proper middleware layer. MuleSoft or an equivalent integration platform gets deferred to “phase two.” Phase two never comes. Instead, the org accumulates direct API connections: ERP to Salesforce, marketing platform to Salesforce, data warehouse to Salesforce, each with its own authentication model, error handling approach, and retry logic.
When one of those connections breaks, the failure is invisible until a business process stops working. There’s no centralized monitoring, no circuit breaker, no dead letter queue. The Salesforce admin gets a ticket saying “the data is wrong” and has to reverse-engineer which of six integrations caused the problem.
The architectural consequence is that the org becomes brittle in proportion to the number of point-to-point connections. Adding a new system requires touching every existing integration that shares data with it. Migrating to a new ERP becomes a multi-year project not because of the ERP migration itself, but because of the integration web that has to be untangled first.
MuleSoft as a centralized integration layer is not just an architectural preference; it’s the difference between a system that can evolve and one that can’t. The salesforce data cloud vs mulesoft integration article makes the case for where each layer belongs in the stack.
What Happens When User Adoption Is Treated as a Training Problem
Low adoption is consistently misdiagnosed. The standard response is more training, better documentation, executive sponsorship messaging. None of that addresses the actual cause.
In practice, adoption failures trace back to one of three architectural problems. First, the system doesn’t reflect how users actually work, because requirements were gathered from managers rather than the people doing the work. Second, the system is slower than the workaround it replaced, because the data model is overcomplicated or the UI is buried under irrelevant fields. Third, the system doesn’t give users anything they didn’t have before, because the implementation was scoped around data capture for reporting rather than workflow support for the end user.
All three are design failures, not training failures. Training can teach someone how to use a system. It cannot make a poorly designed system worth using.
The architectural principle here is that adoption is a design constraint, not a post-launch activity. Every Flow, every page layout, every required field is a friction point. The question during design is whether that friction is justified by the business outcome it enables. When the answer is “we need this for reporting,” the follow-up question should be whether there’s a way to get the data without requiring the user to enter it manually.
How to Diagnose Before You Prescribe
The failure patterns above rarely appear in isolation. A data model problem usually coexists with a governance gap. An integration architecture problem usually coexists with an adoption problem, because users can’t trust data that arrives inconsistently from broken integrations.

Effective diagnosis requires a structured assessment that looks at the org across four dimensions simultaneously: data model integrity, integration architecture, governance maturity, and user experience design. The salesforce org health check assessment guide provides the framework for running that assessment systematically.
The output of that assessment should be a prioritized remediation backlog, not a list of everything that’s wrong. The distinction matters because most orgs in distress cannot fix everything at once. The architectural question is which problems are blocking everything else. A broken data model blocks Data Cloud activation, Agentforce deployment, and reporting accuracy simultaneously. Fix that first.
For orgs that have already crossed into active project failure, the /services/org-health-recovery work starts with exactly this triage: identifying the structural failures that are compounding everything else, and sequencing remediation to stop the bleeding before optimizing.
Key Takeaways
- Salesforce implementation failure root causes are almost always architectural, not technological. The platform works; the design decisions around data model, integration, and governance are where projects break.
- Requirements gathered without architectural authority produce configurations that automate broken processes at high fidelity. Solution architects need to be in discovery, not just in build.
- Deviations from Salesforce’s standard data model compound over time. Every custom object and junction object increases the cost of future changes, including Data Cloud and Agentforce adoption.
- Treat integration architecture as a first-class decision. Point-to-point connections deferred to “phase two” become the primary reason orgs can’t evolve their stack.
- Low adoption is a design failure. No amount of training compensates for a system that is slower, more complex, or less useful than the workflow it replaced.
